Underground Pipe and Asphalt Replacement

UPAR

2026 UPAR Projects schedule

Scheduled dates may change due to weather, and other delays. Thank you for your patience during our short construction season.

  • Concrete: To be scheduled
  • Hydrant: Not applicable
  • Milling: June 23 to June 28, 2026
  • Paving: June 29 to July 5, 2026

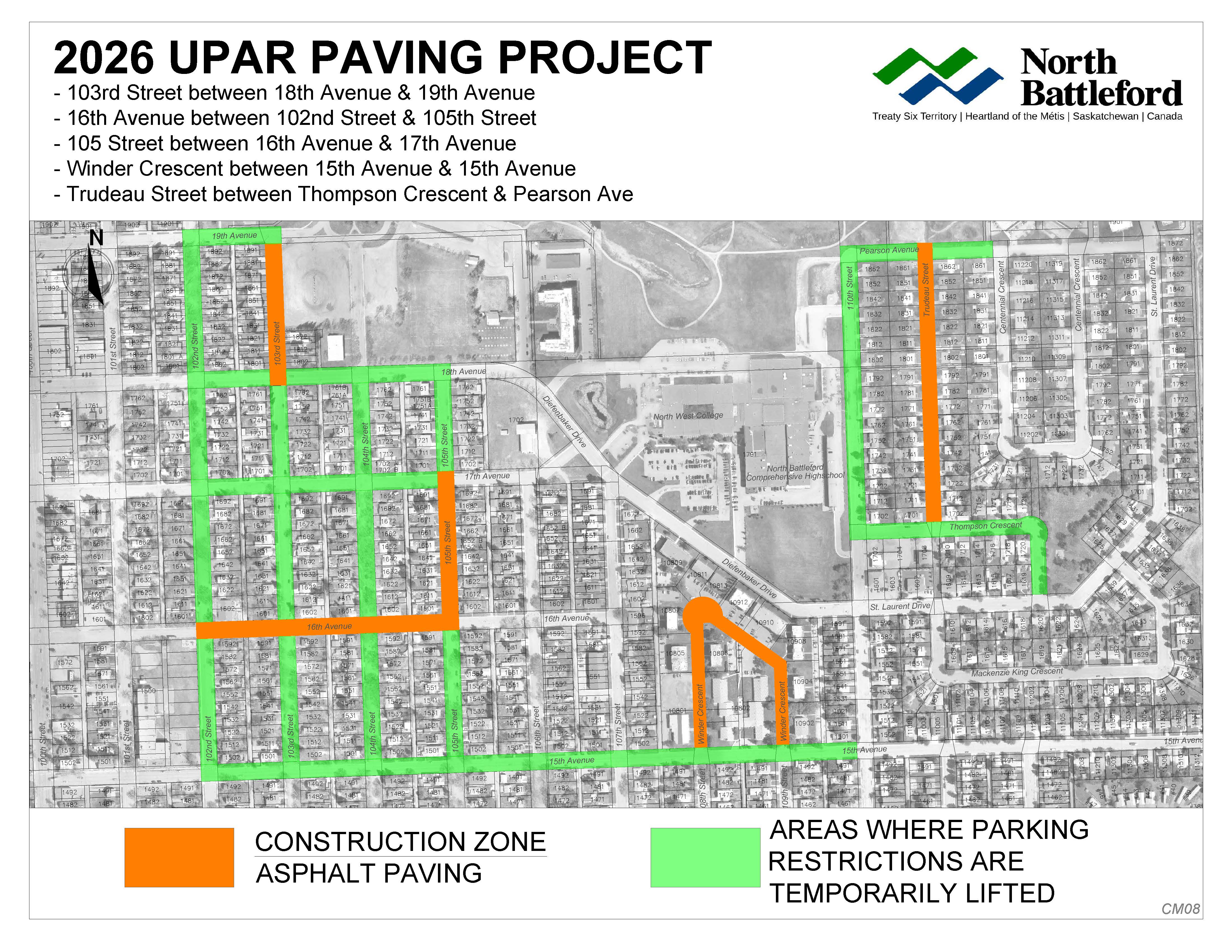

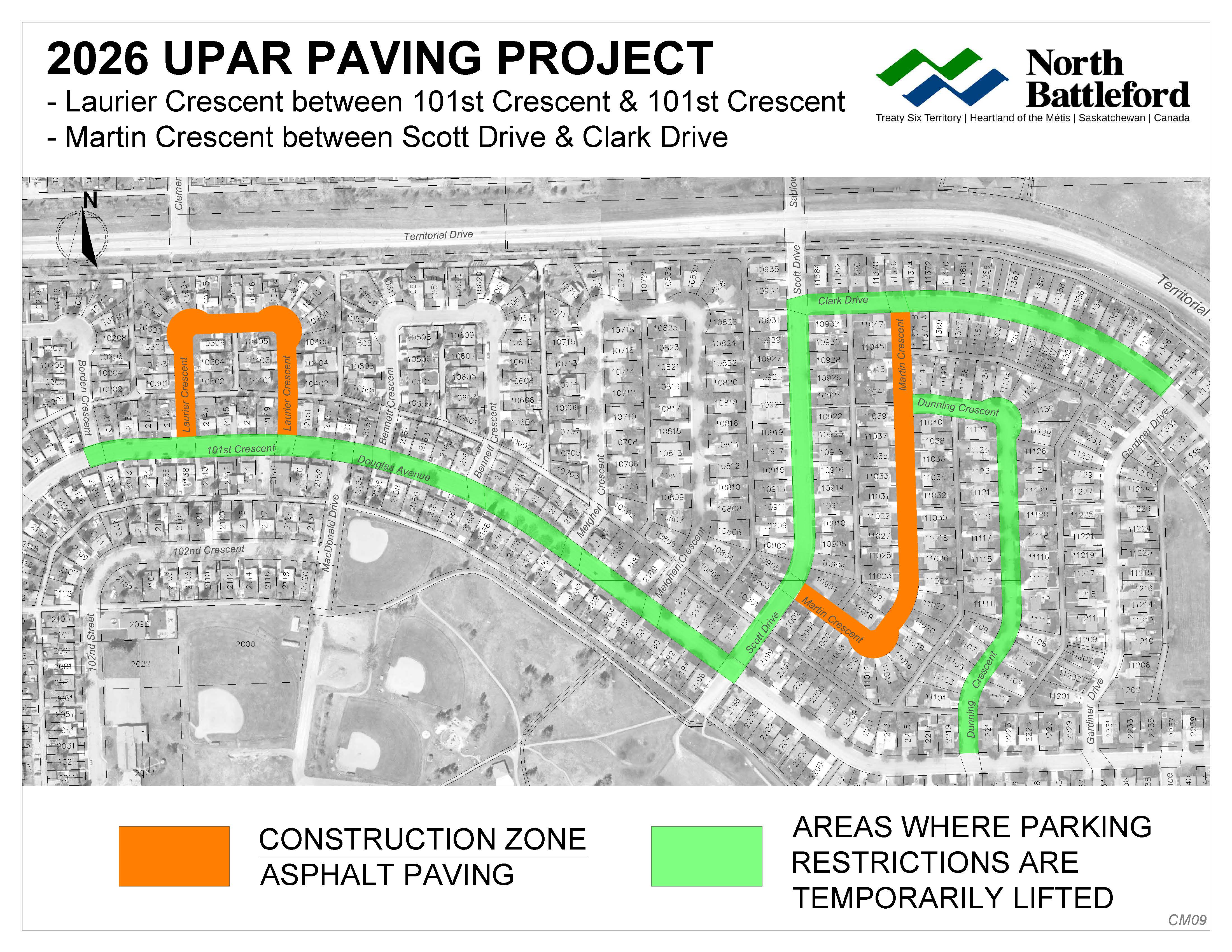

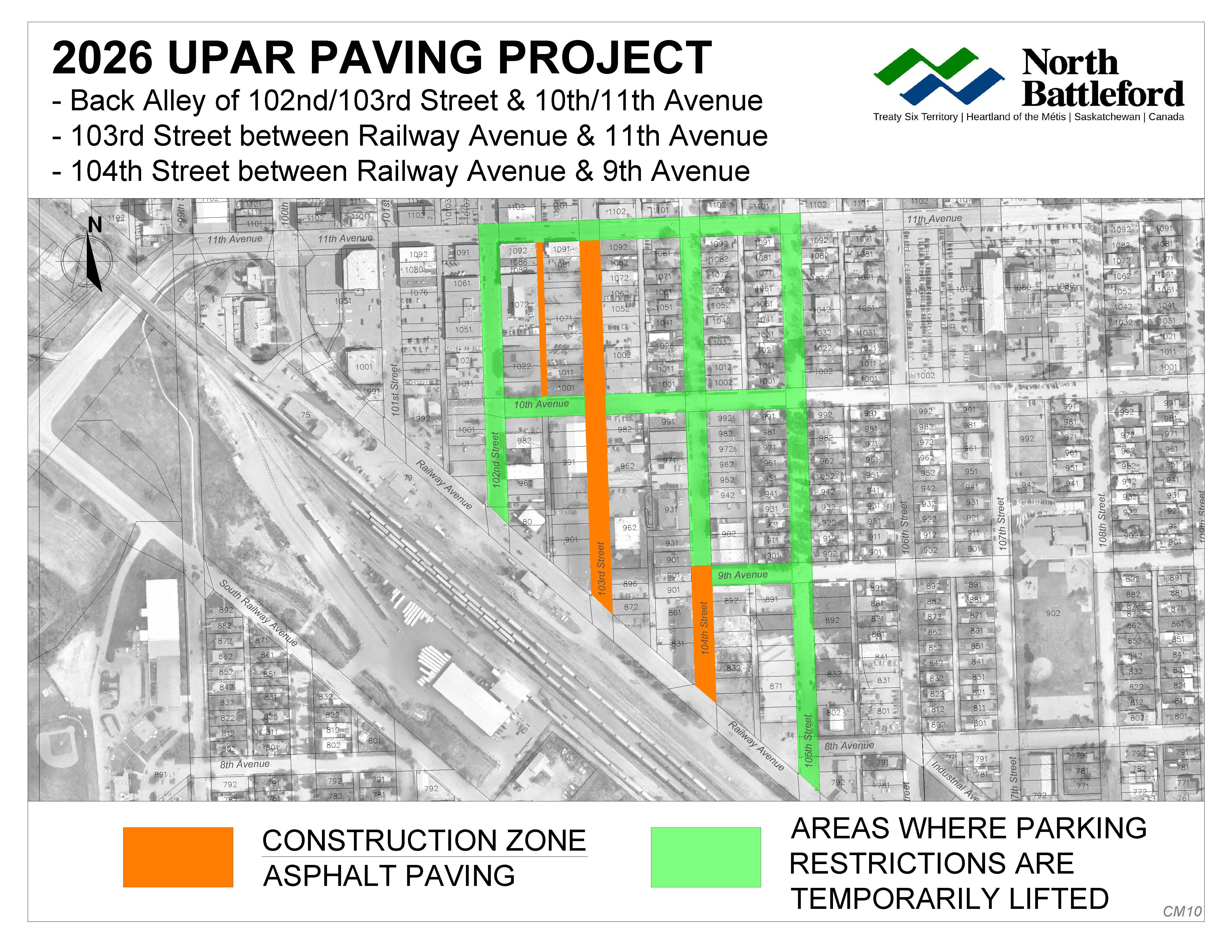

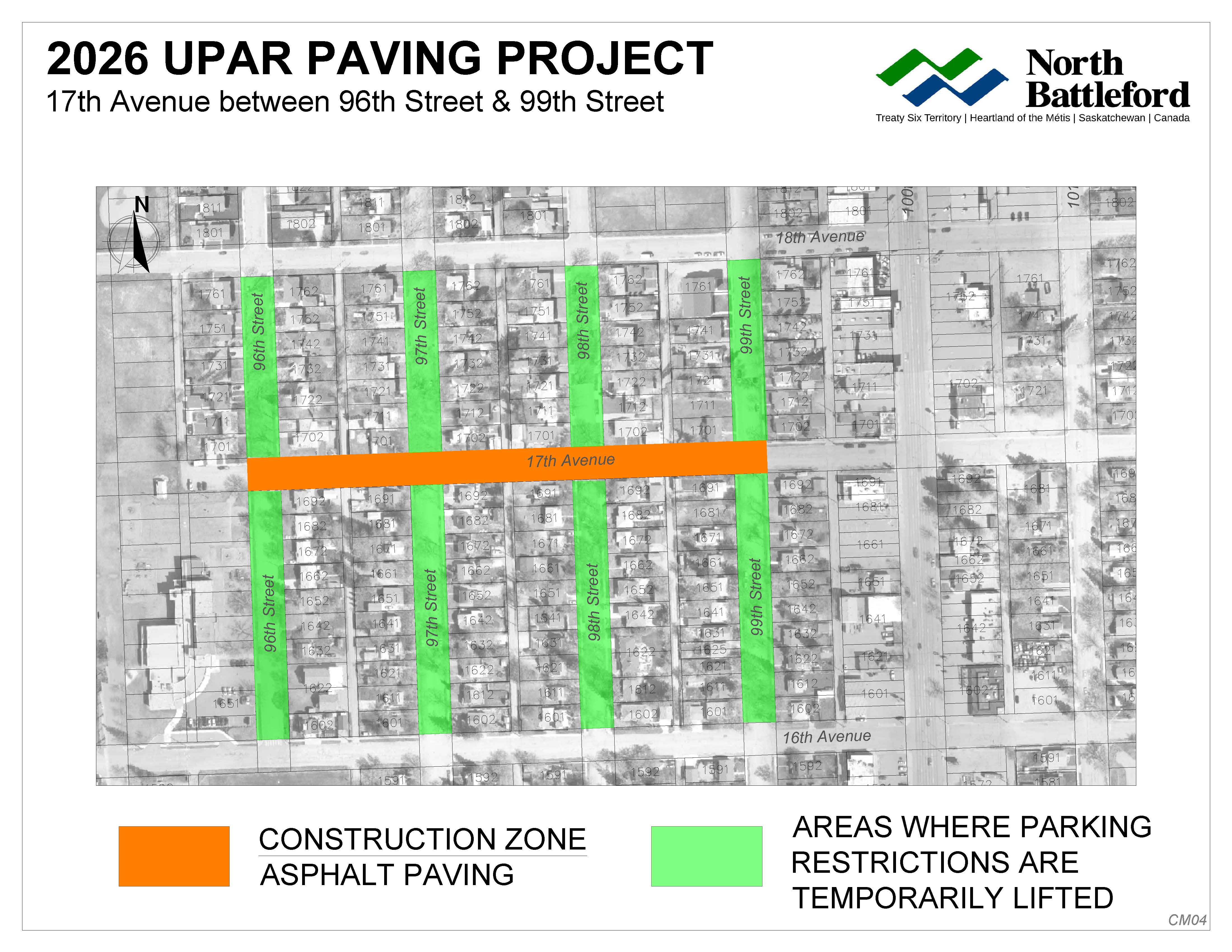

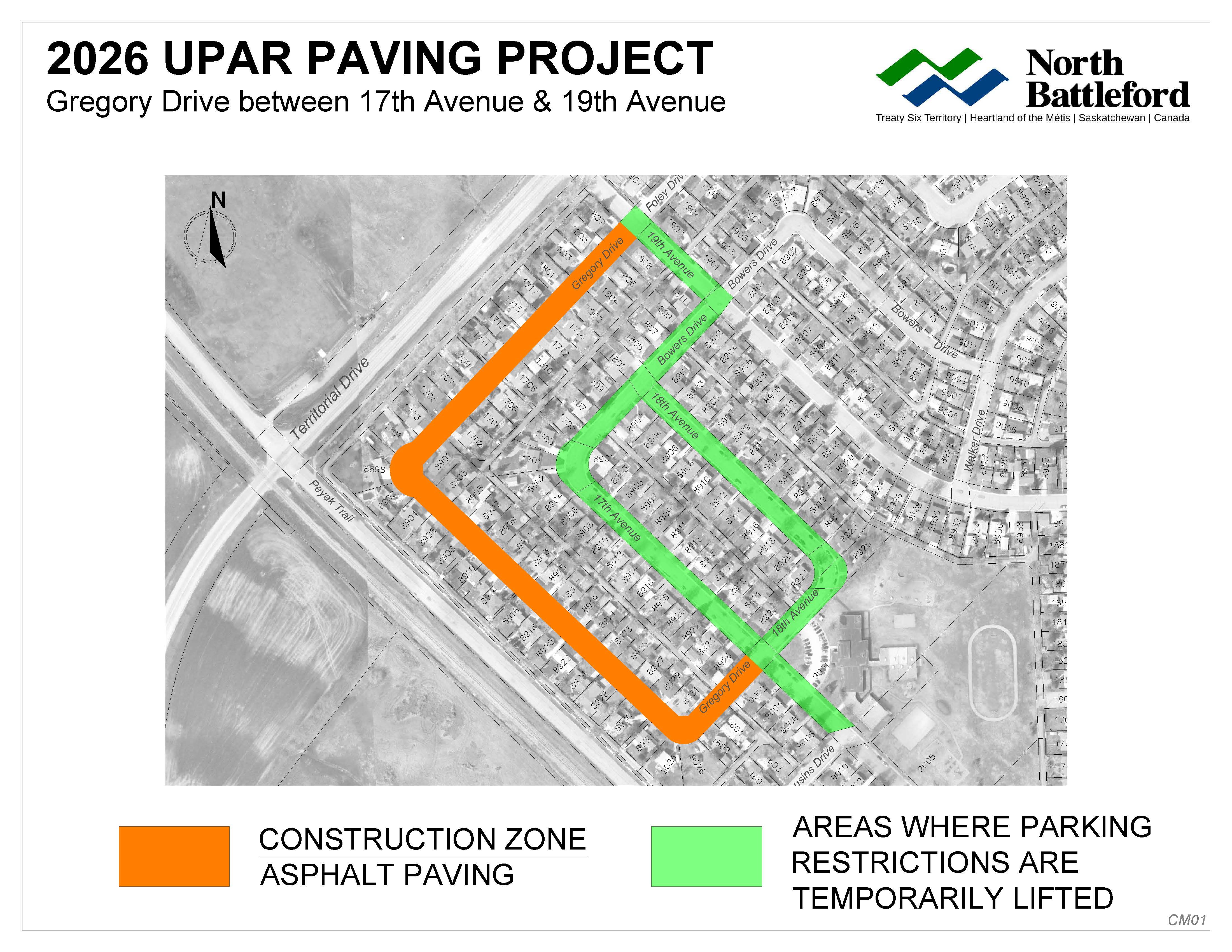

During milling and paving activities, you won't be able to park on the street in this area.

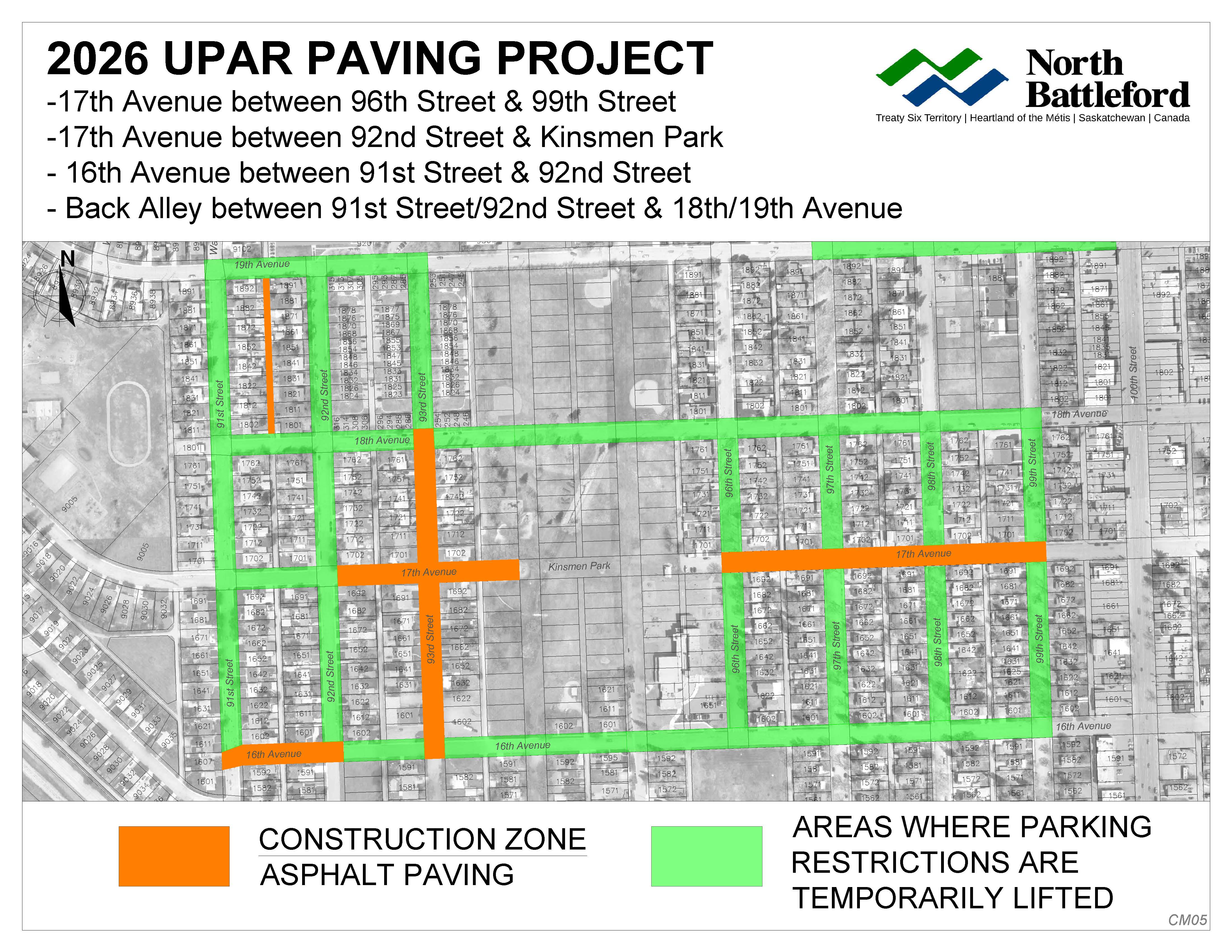

View the construction and parking map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 28 to August 2, 2026
  • Paving: July 3 to August 9, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 16 to July 21, 2026
  • Paving: July 22 to July 28, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.



  • Concrete: Not applicable
  • Hydrant: June 15 to June 24, 2026
  • Milling: August 6 to August 11, 2026
  • Paving: August 12 to August 18, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: August 6 to August 11, 2026
  • Paving: August 12 to August 18, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

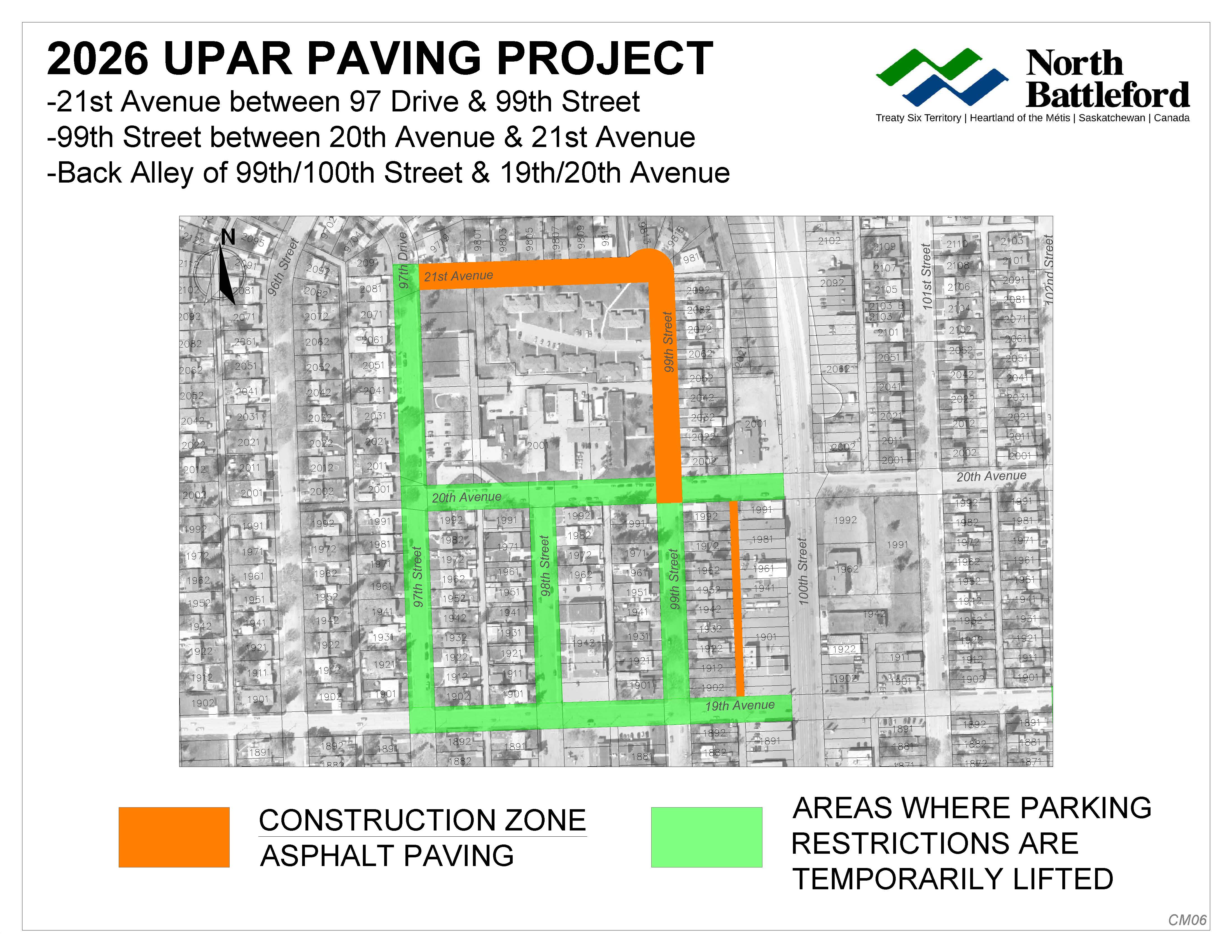

21st Avenue between 97th Drive and 99th Street and 99th Street between 20th and 21st Avenue

  • Concrete: June 10, 2026 to June 26, 2026
  • Hydrant: June 8 to June 17, 2026
  • Milling: July 16 to July 21, 2026
  • Paving: July 22 to July 28, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

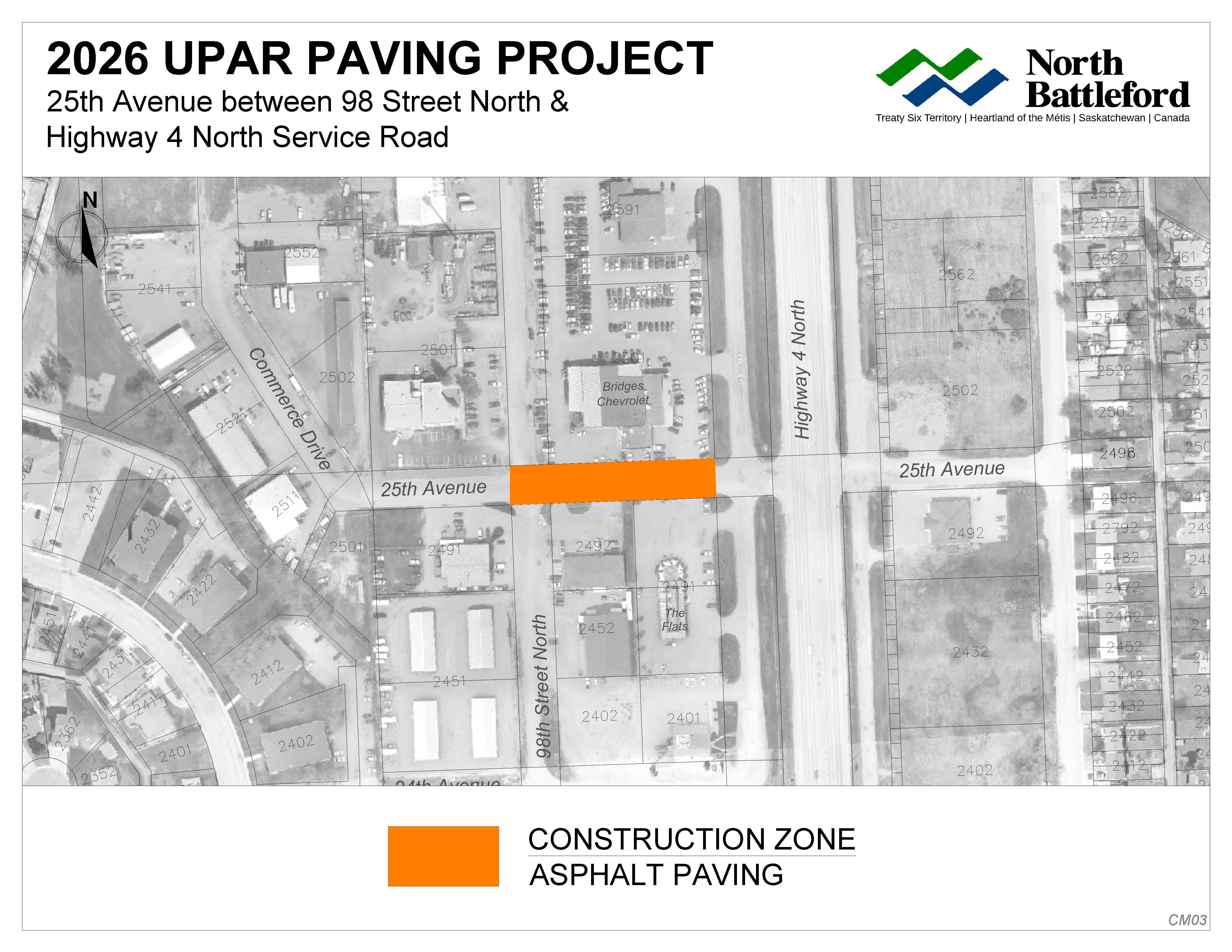

25th Avenue between 98th Street North and 99th Street Service Road / Highway 4 North

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: June 8 to June 13, 2026
  • Paving: June 14 to June 20, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 6 to July 11, 2026
  • Paving: July 12 to July 18, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: June 1 to June 17, 2026
  • Hydrant: Not applicable
  • Milling: June 18 to June 23, 2026
  • Paving: June 24 to June 30, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: Not applicable
  • Paving: Not applicable
This project is currently deferred pending future planning considerations.

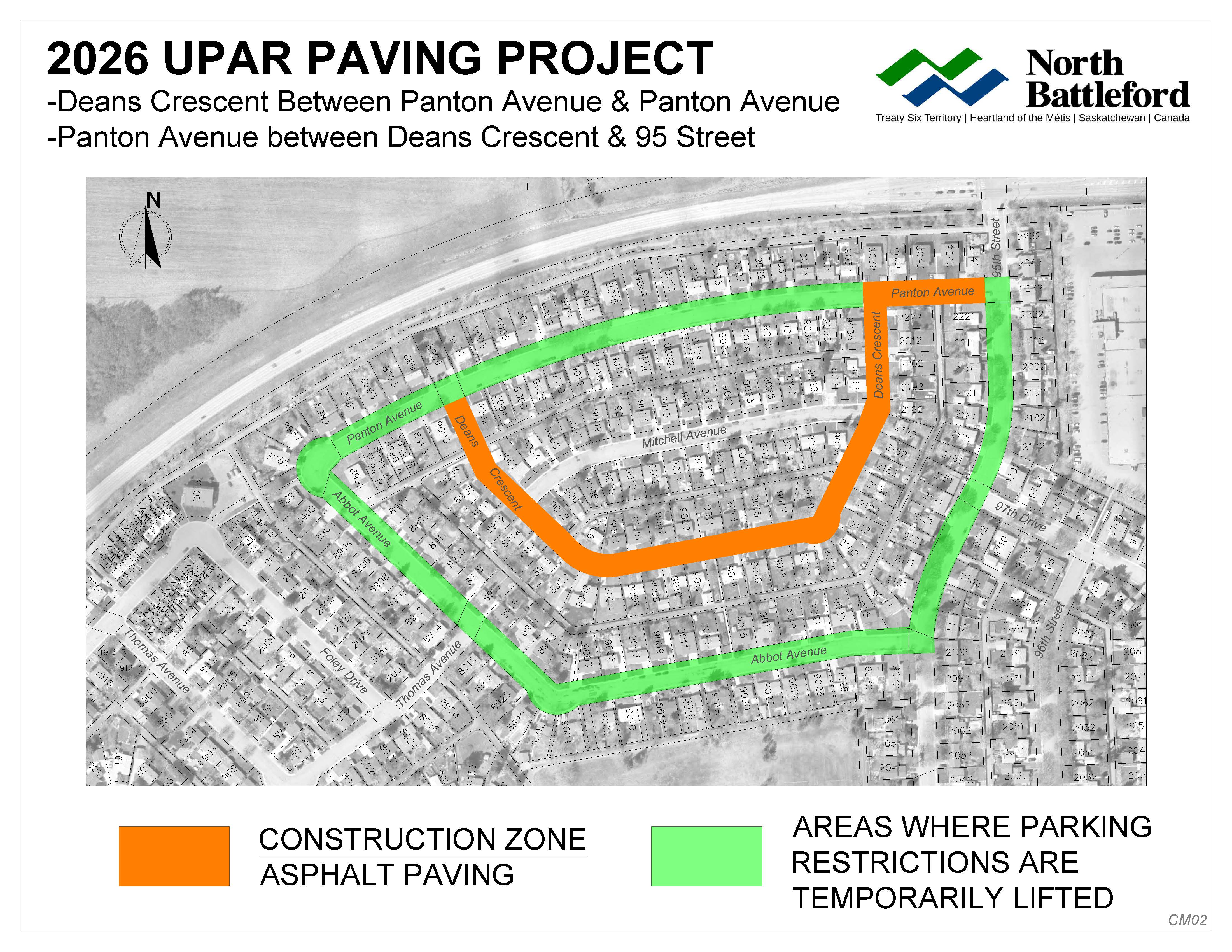

Deans Crescent between Panton Avenue and Panton Avenue between Deans Crescent and 95th Drive

  • Concrete: August 1 to August 17, 2026
  • Hydrant: ✅ Complete
  • Milling: August 18 to August 23, 2026
  • Paving: August 24 to August 30, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: July 13 to July 29, 2026
  • Hydrant: ✅ Complete
  • Milling: August 4 to August 9, 2026
  • Paving: August 10 to August 16, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.



  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 4 to July 9, 2026
  • Paving: July 10 to July 16, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: July 1 to July 17, 2026
  • Hydrant: Not applicable
  • Milling: July 18 to July 23, 2026
  • Paving: July 24 to July 30, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 27 to August 1, 2026
  • Paving: August 2 to August 8, 2026
During milling and paving activities, access will be limited in this area.
View the construction map to plan an alternative route.

  • Concrete: Not applicable
  • Hydrant: Not applicable
  • Milling: July 2 to July 7, 2026
  • Paving: July 8 to July 14, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

  • Concrete: ✅ Complete
  • Hydrant: Not applicable
  • Milling: July 14 to July 19, 2026
  • Paving: July 20 to July 26, 2026
During milling and paving activities, you won't be able to park on the street in this area.
View the construction and parking map to see where you can find parking nearby.

UPAR Information

Each year, the City Council approves several infrastructure improvement projects in North Battleford, funded by a portion of the taxes paid by property owners through the Underground Pipe & Asphalt Replacement (UPAR) levy.

UPAR construction is scheduled to take place from mid-May through the fall of this year. Timelines will be communicated to community members in advance, particularly to those whose neighbourhoods and properties will be directly affected by the necessary work conducted by the City and its contractor.

UPAR

Underground Pipe & Asphalt Replacement

MAC

Maximum Accepted Concentration

Sanitary Sewer

An underground pipe or tunnel system for transporting sewage from houses and commercial buildings (but not stormwater) to a sewage treatment plant for disposal.

Sub-base

The layer of aggregate material that lies immediately below the pavement and usually consists of crushed aggregate or recycled materials

Milling

The process of removing at least part of the surface of a paved area such as a road, bridge, or parking lot

Service Line

The pipe or conduit, water meter, and valves connected on one end to the curb stop, the other end terminating inside the User's building, to provide water service

Potable Water

Water that is considered safe to drink

Service Trench

Used for installation of underground infrastructure or utilities (such as gas mains, water mains, communication lines, and pipelines)

Temporary Service

A 1-1/4" poly service line that will be set up in your back alley (commercial) or in the front of your property (residential) to provide alternate accessibility to City main water lines during construction periods - intended to provide the property owner with access to (non-potable) water during lengthy service disruptions - a boil water advisory accompanies a temporary service to ensure the water is safe for human consumption



The City of North Battleford is legally required to replace any lead service lines encountered during the underground UPAR work. Property owners can take advantage of this opportunity to replace their water and sewer lines with updated materials (if not lead) at a reduced cost.

For more information, contact 306-441-0359 (text or call).

The deadline for property owners to request replacement of their underground laterals was May 15, 2025.

To ensure garbage and recycling cart pickups are not missed for the properties within a UPAR construction area, residents are asked to put their collection bins in front of their residence and the UPAR contractors will move the bins to a location where they can be accessed by Loraas.

For any questions, please contact 306-441-0359

During the UPAR project, parking restrictions for property owners on blocks currently under construction will not be enforced. Property owners may park on adjacent blocks to access their properties during the construction period.

Details to come later.

Additional Information

Public information sessions will be held on Zoom every two weeks for the duration of the project, featuring updates and timelines from the contractors completing the UPAR work.

Information session dates to be posted when dates are established.

Thank you

We understand that this process, while necessary, can be frustrating for our community. We appreciate your cooperation and encourage you to reach out with any questions or concerns.

Project Contact

Department of Engineering, Planning, Asset Management & Infrastructure

1291-101st St
North Battleford, SK
S9A 2Y6

For assistance related to UPAR, please feel free to:
